Document - Report, Public Transport Corporation (PTC), "Tram Maintenance", c1993

Physical description

Set of approx. 48 A4 single sided sheets outlining overhaul procedures and scope of works for Plan Programmed Maintenance (PPM) Has been part of a larger report.

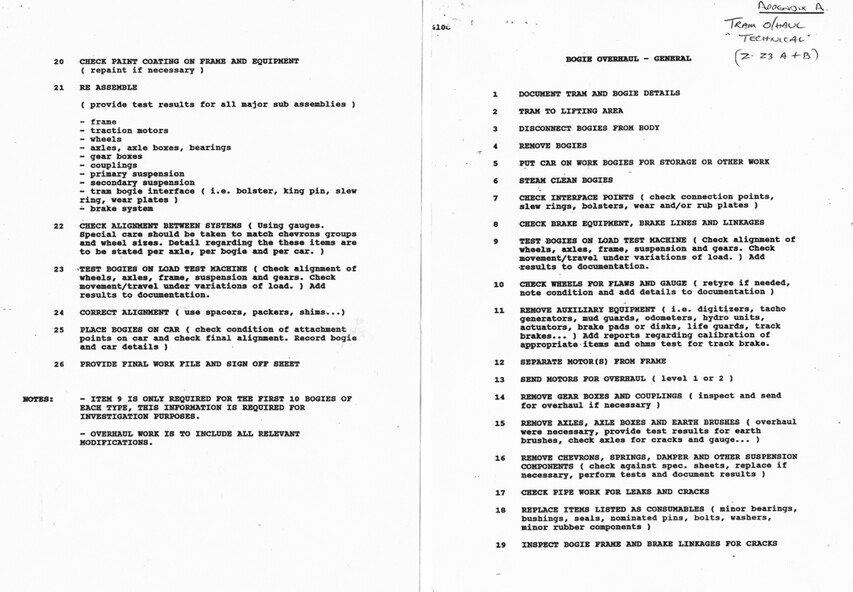

Appendix A - Bogie Overhaul - 2 sheets

B - Rotatating Machines - 2 sheets

PPM Overhaul Schedule - All tram cases - three levels proposed - 1

W class and others trams - 8 sheets

B class - 5 sheets

Z class - 6 sheets

Maintenance and repair overhaul - transformers - 3 sheets

W class and other tram defect report sheets - 2

Bus Maintenance employees/ bus for Australian cities - 1

DH16 Overhaul labour/resource chart - 1

GE 247 motors - ditto - 1

Wheel condition report form - Yarra Trams c2000 - 1

Set of forward planning sheets for tram overhauls from W681 to A300 - c 1991 - 15 sheets.
