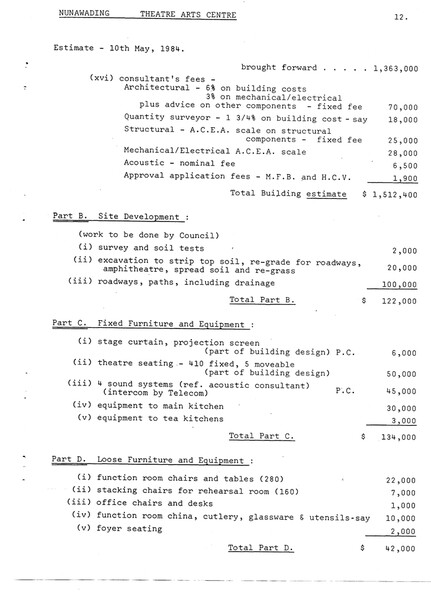

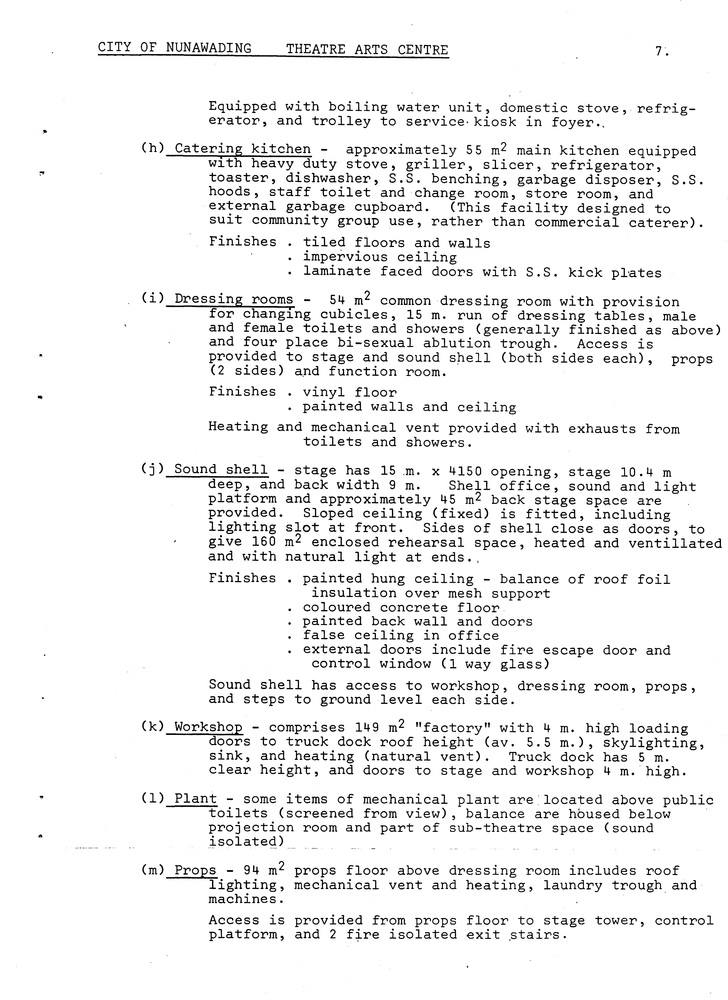

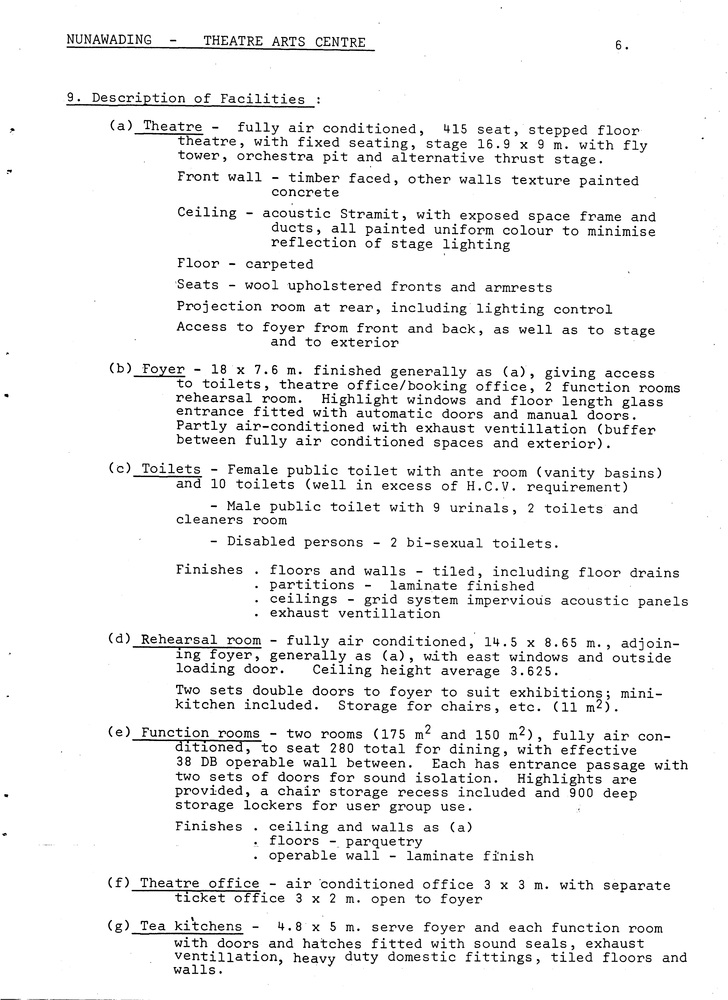

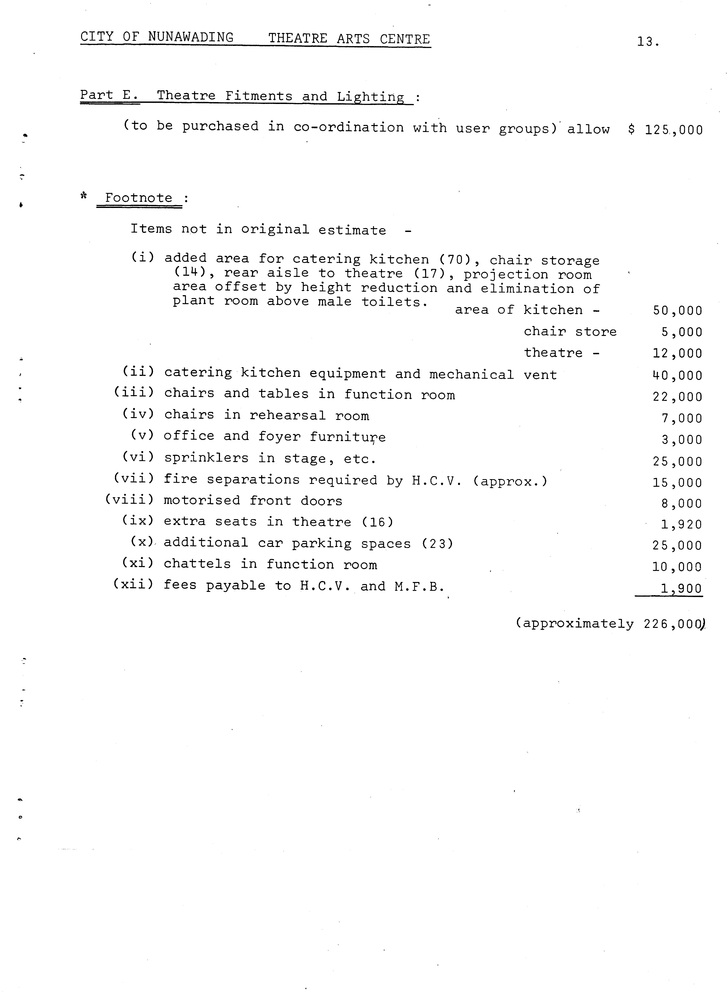

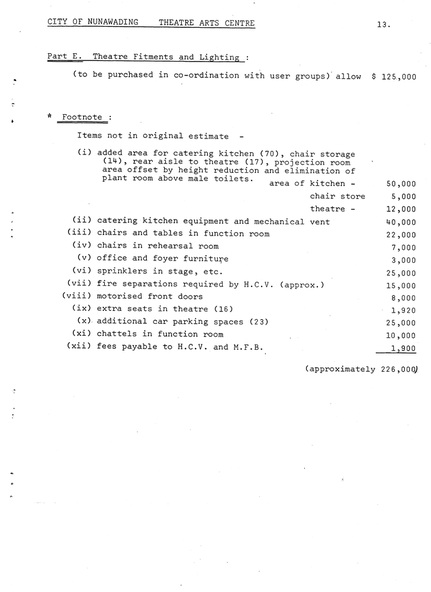

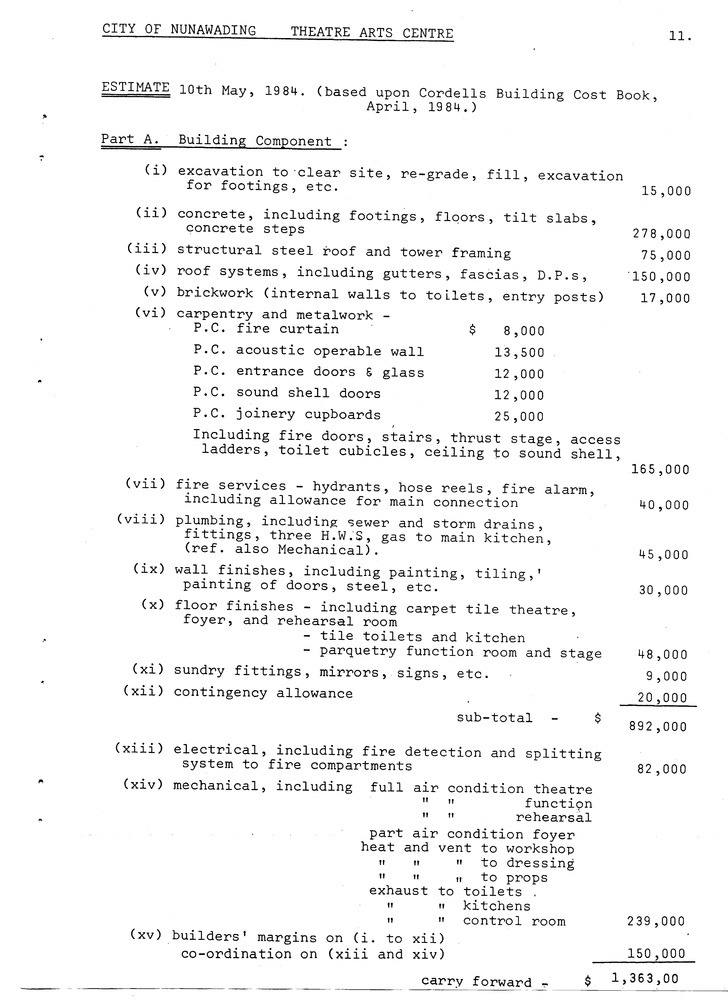

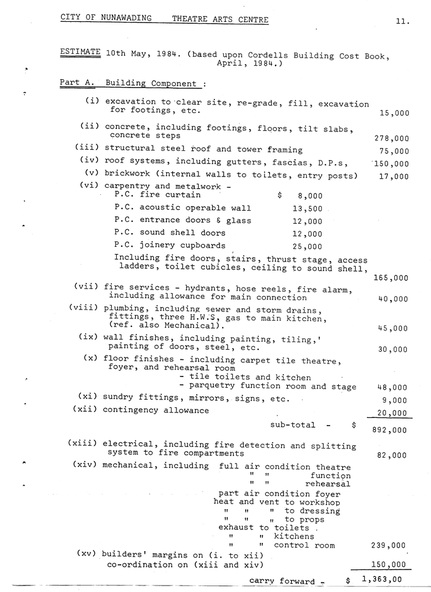

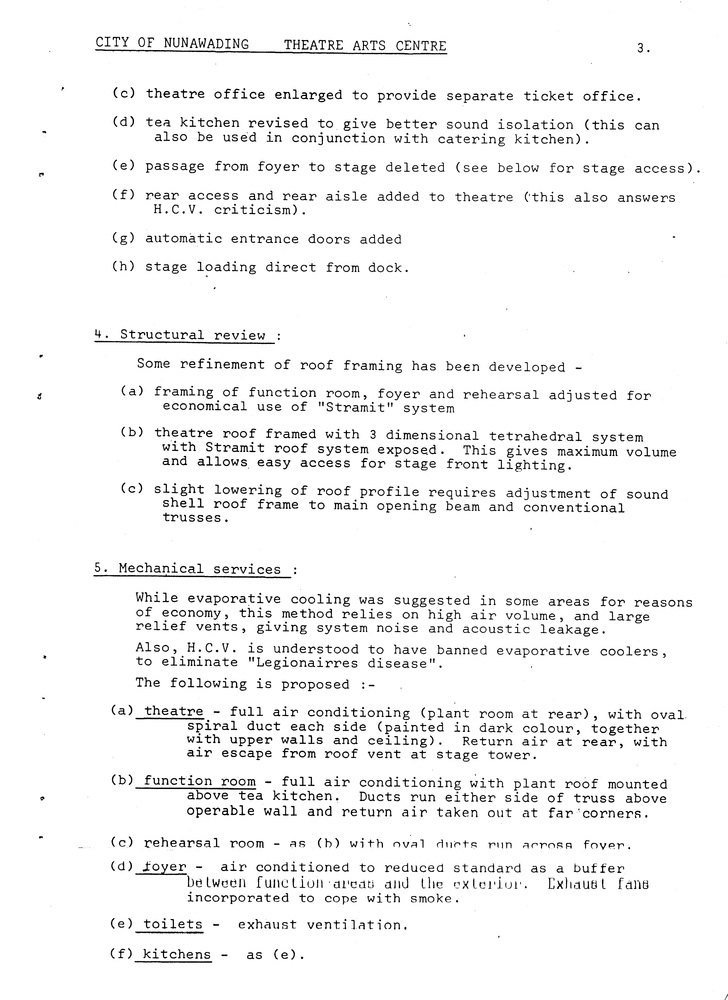

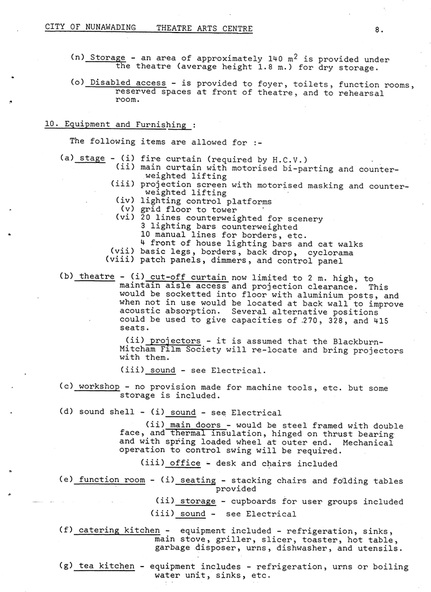

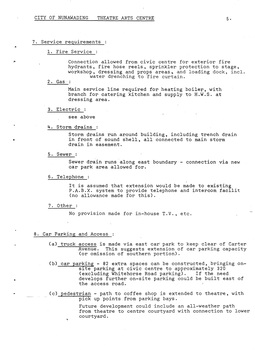

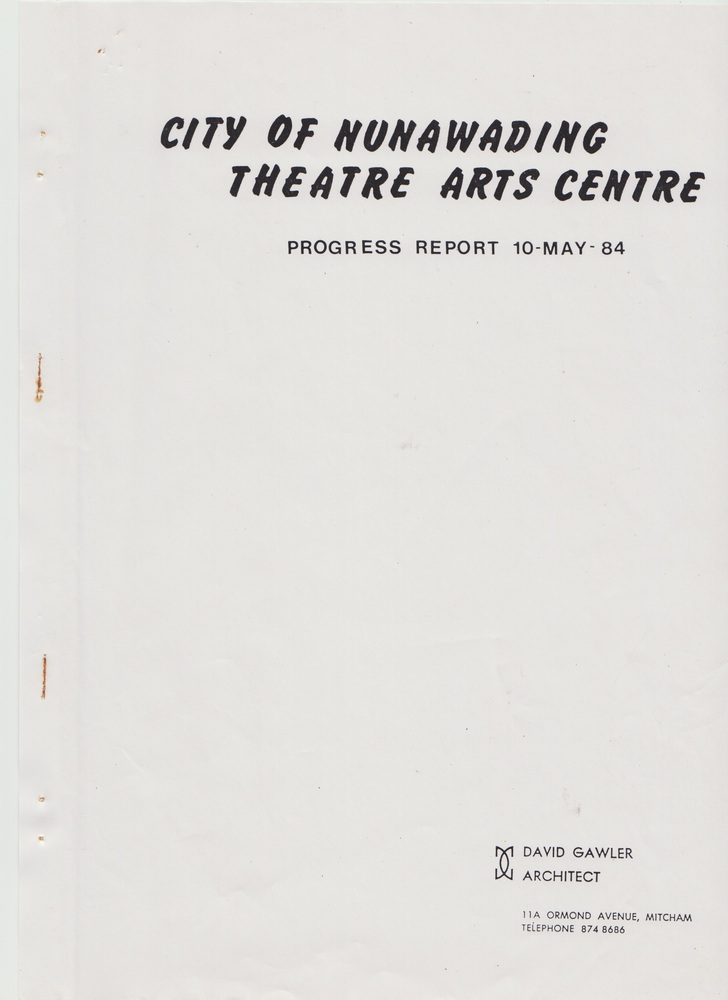

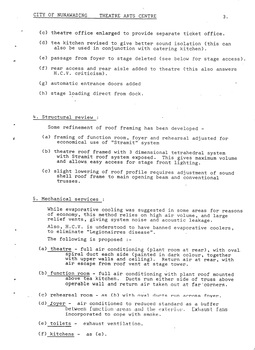

Physical description

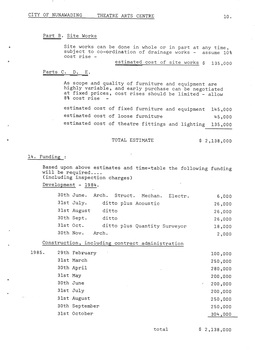

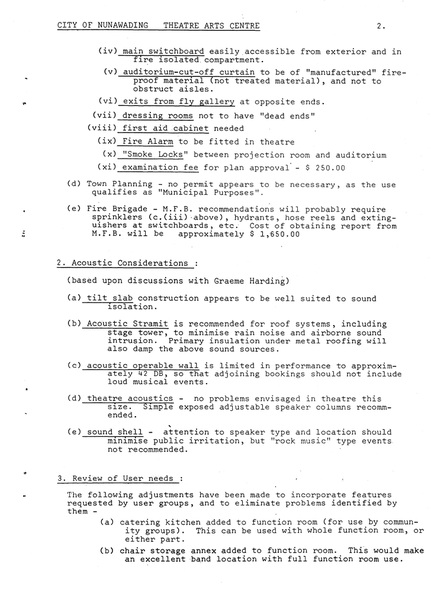

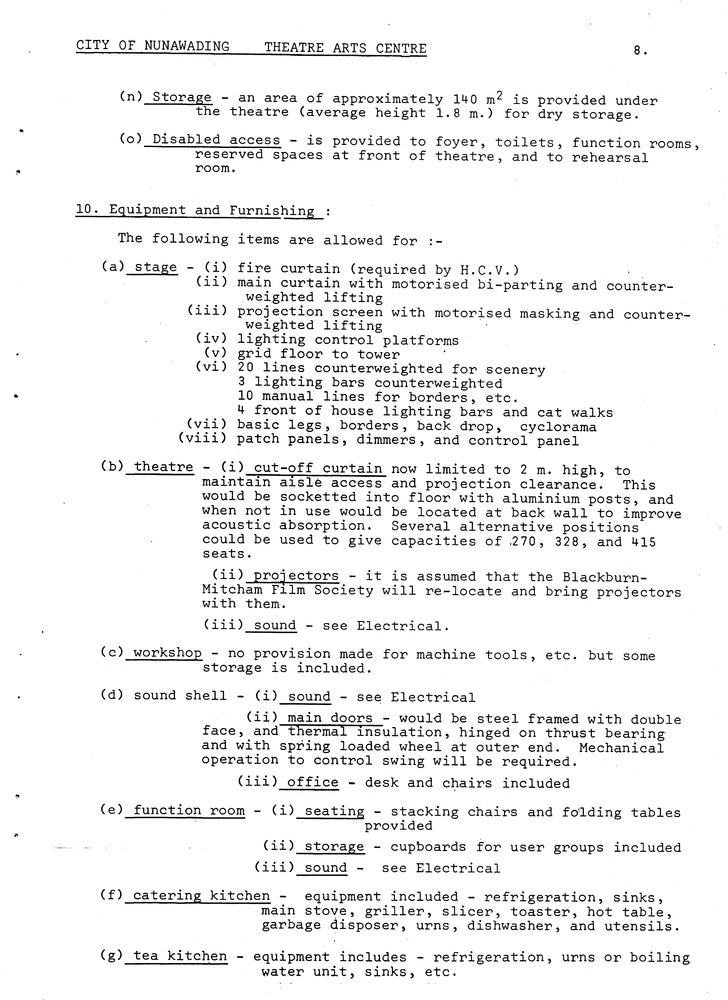

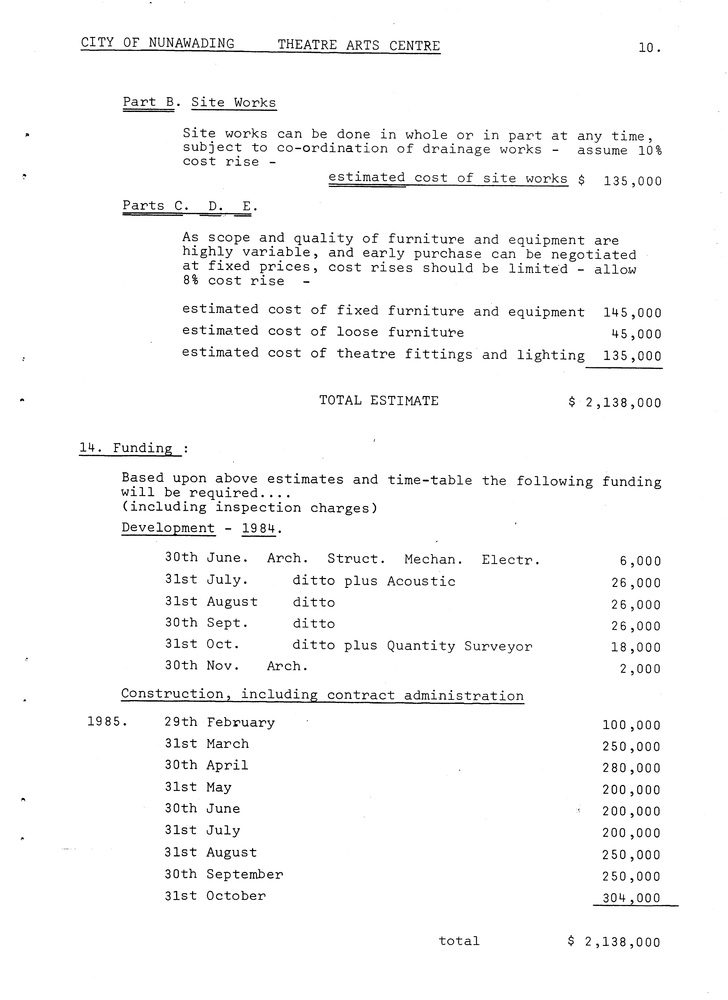

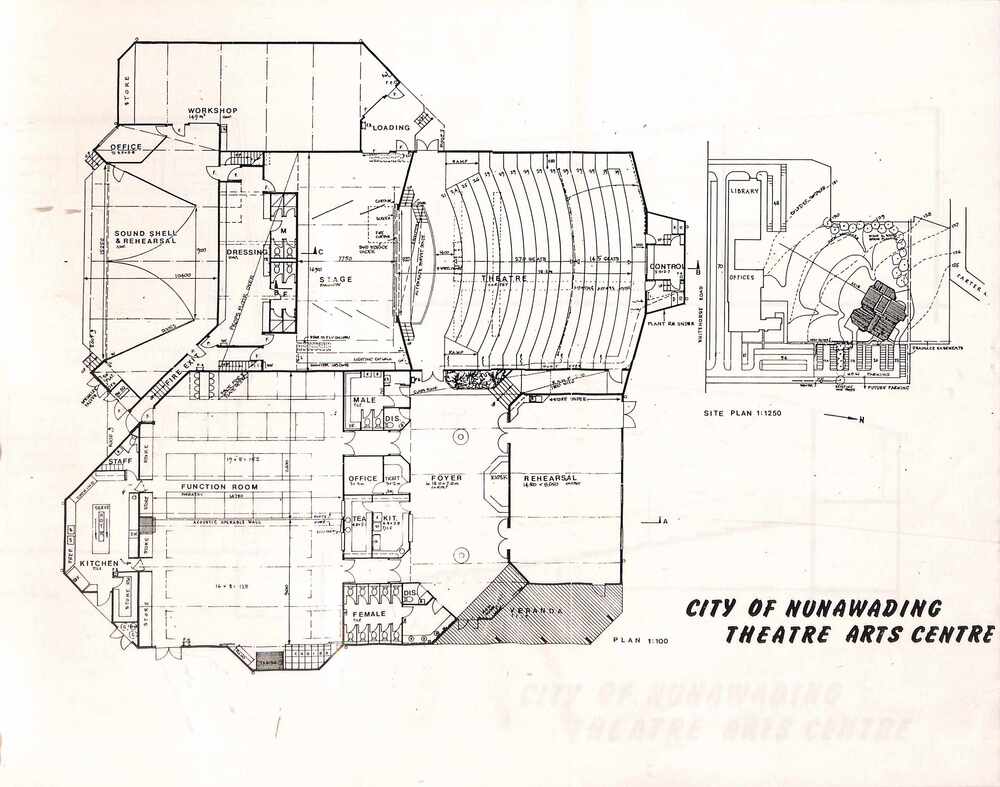

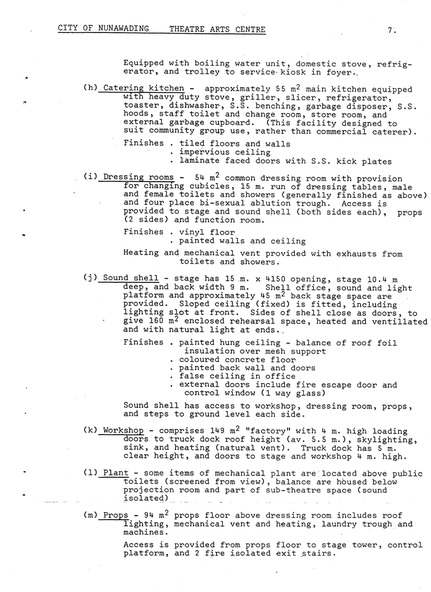

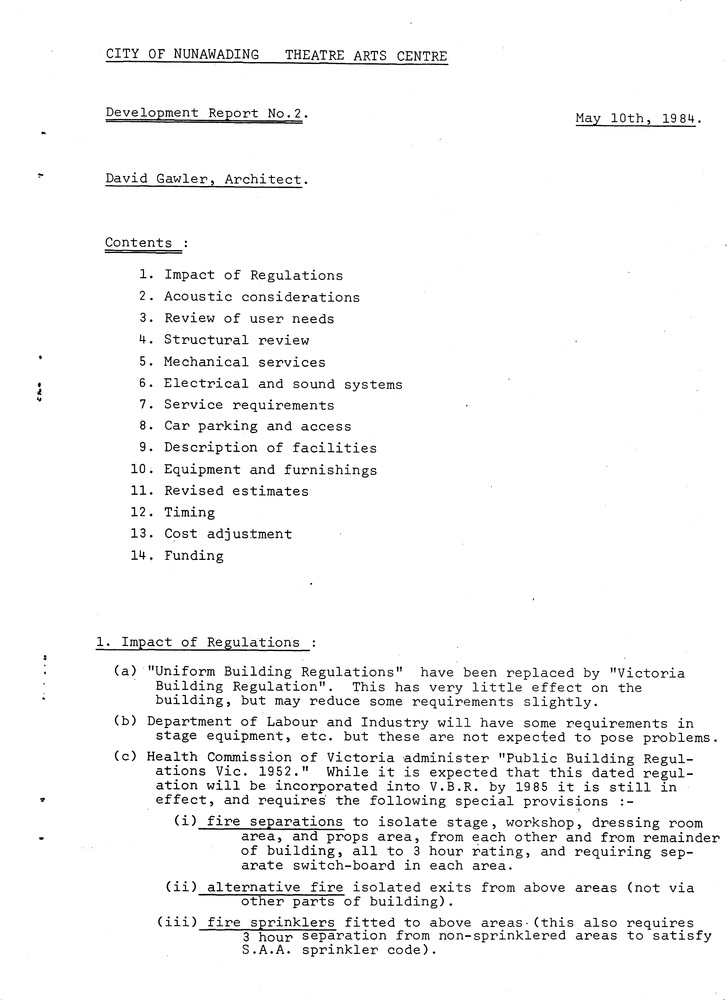

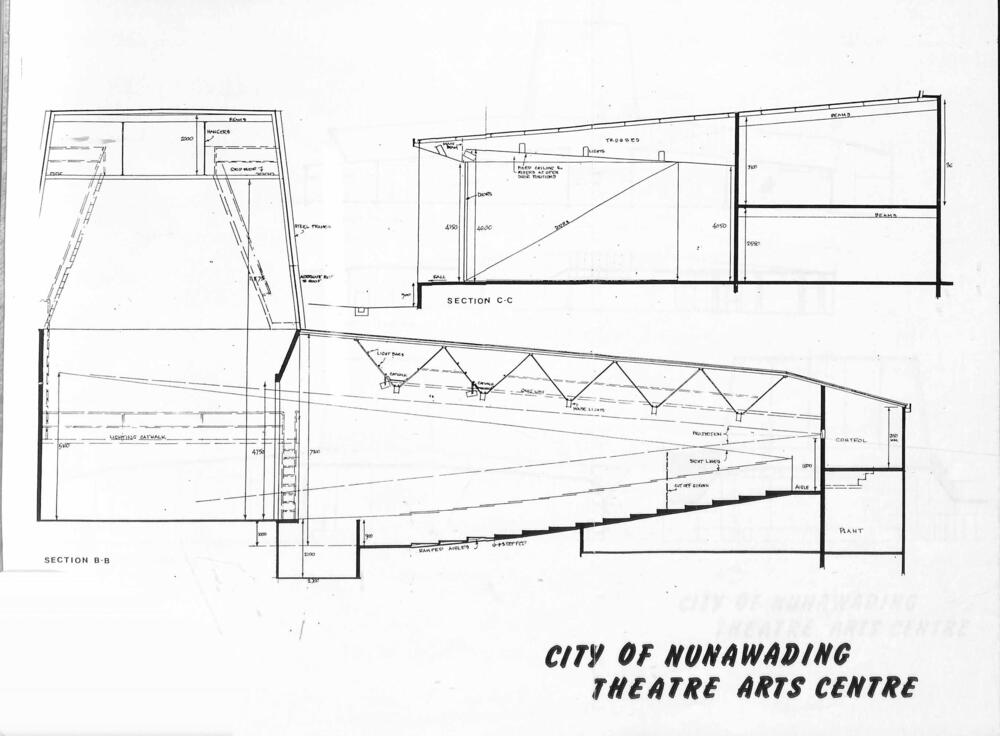

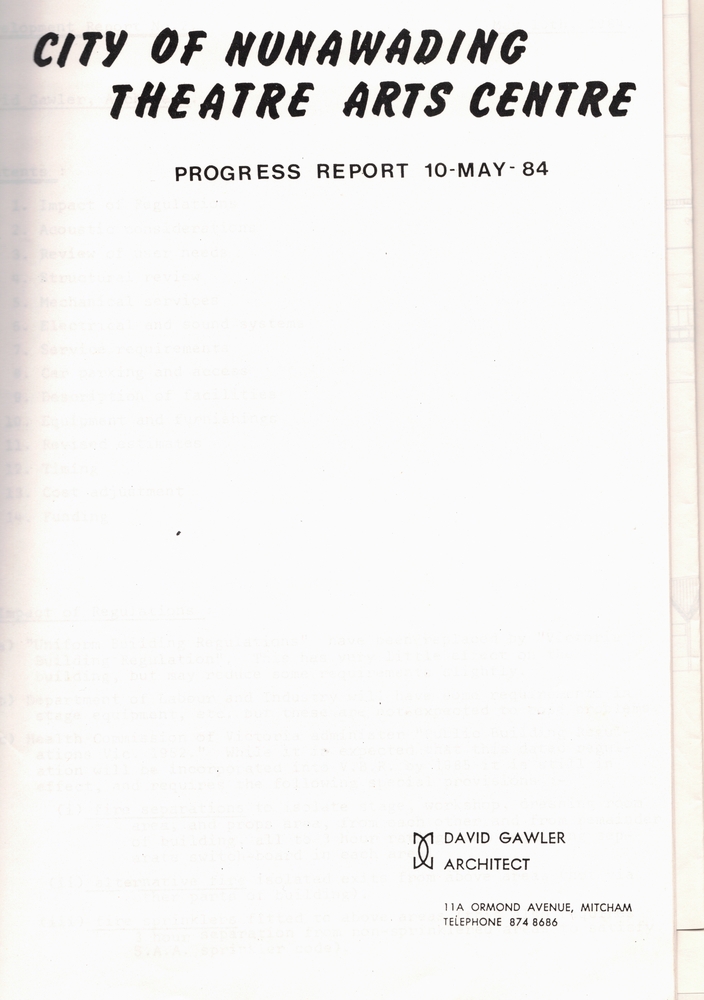

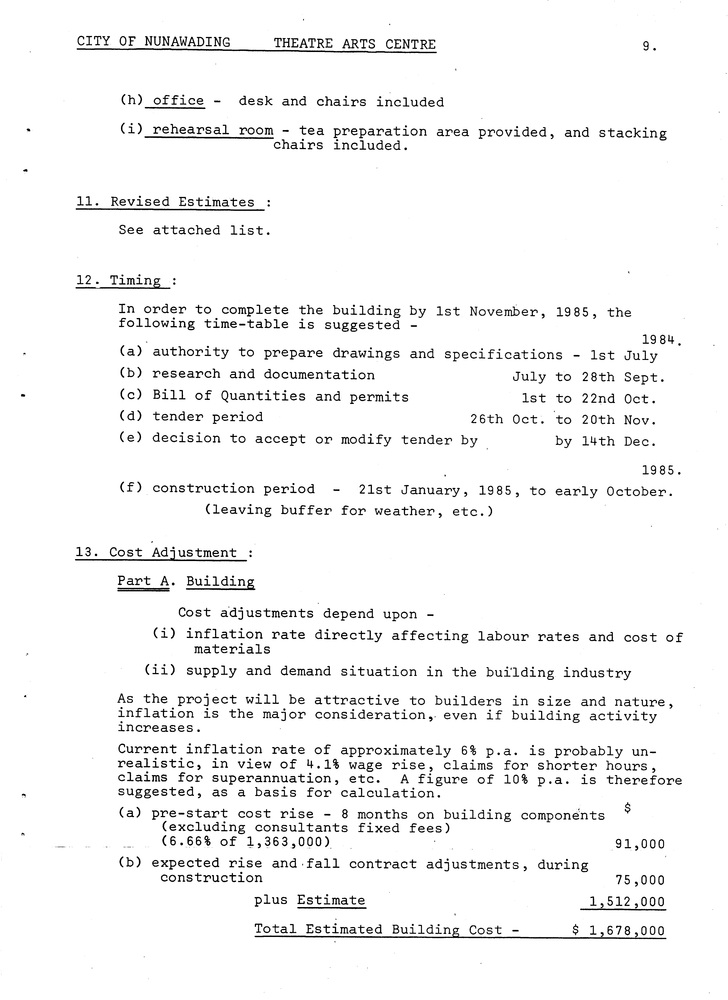

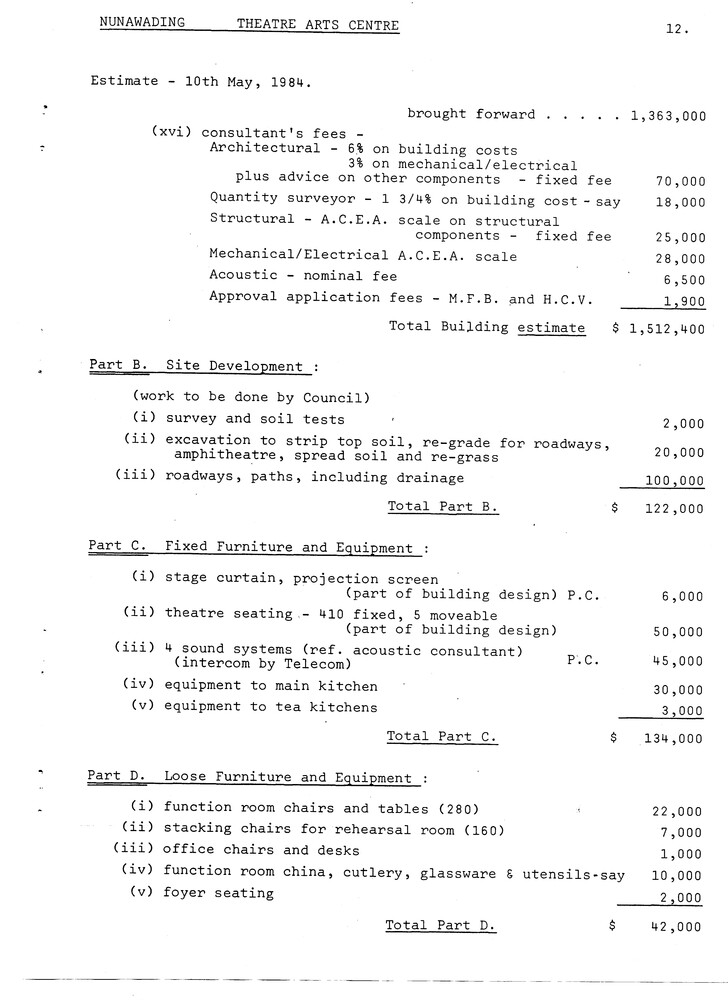

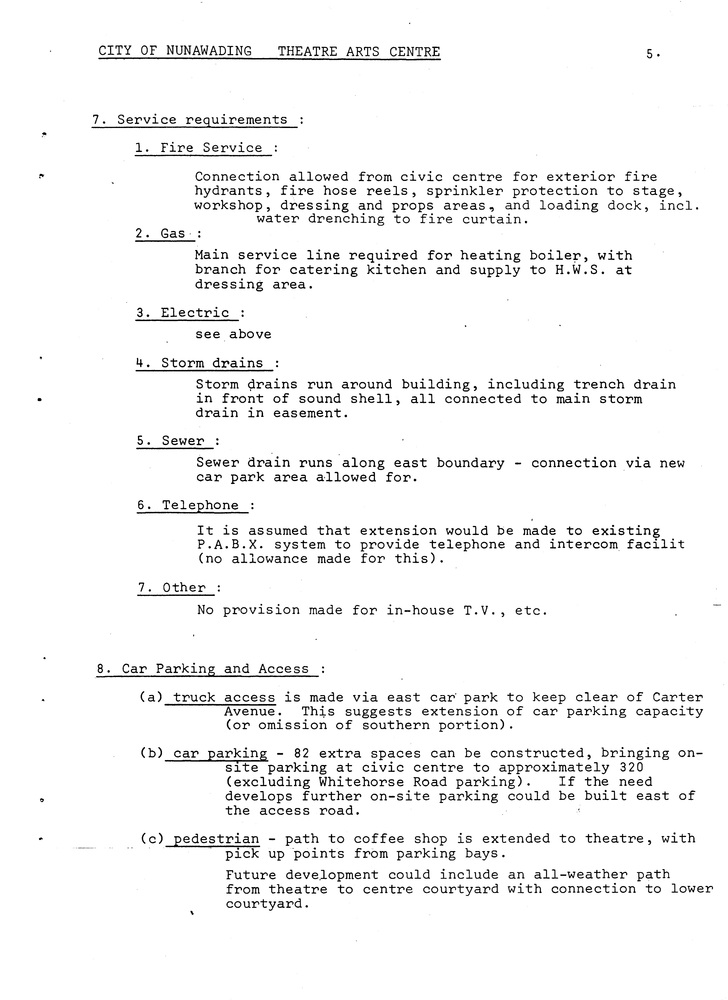

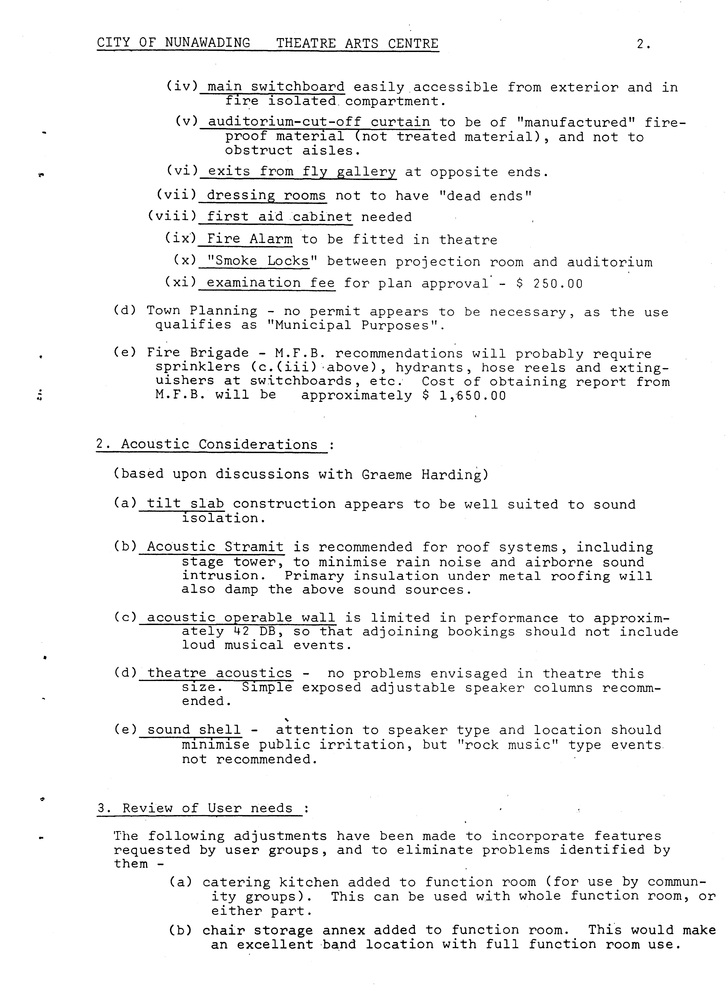

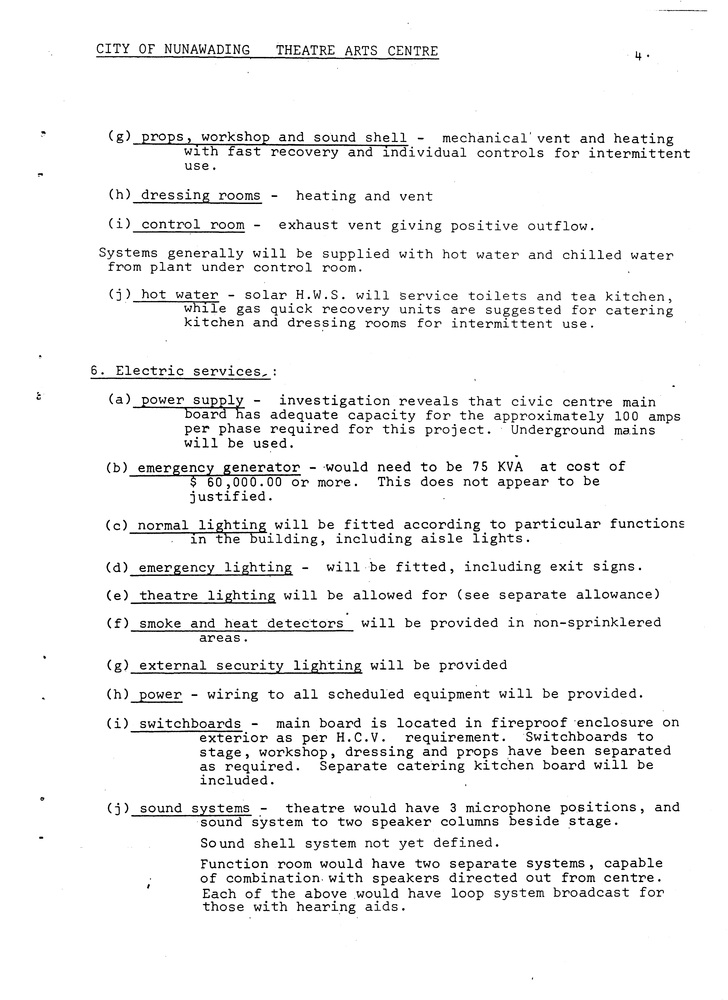

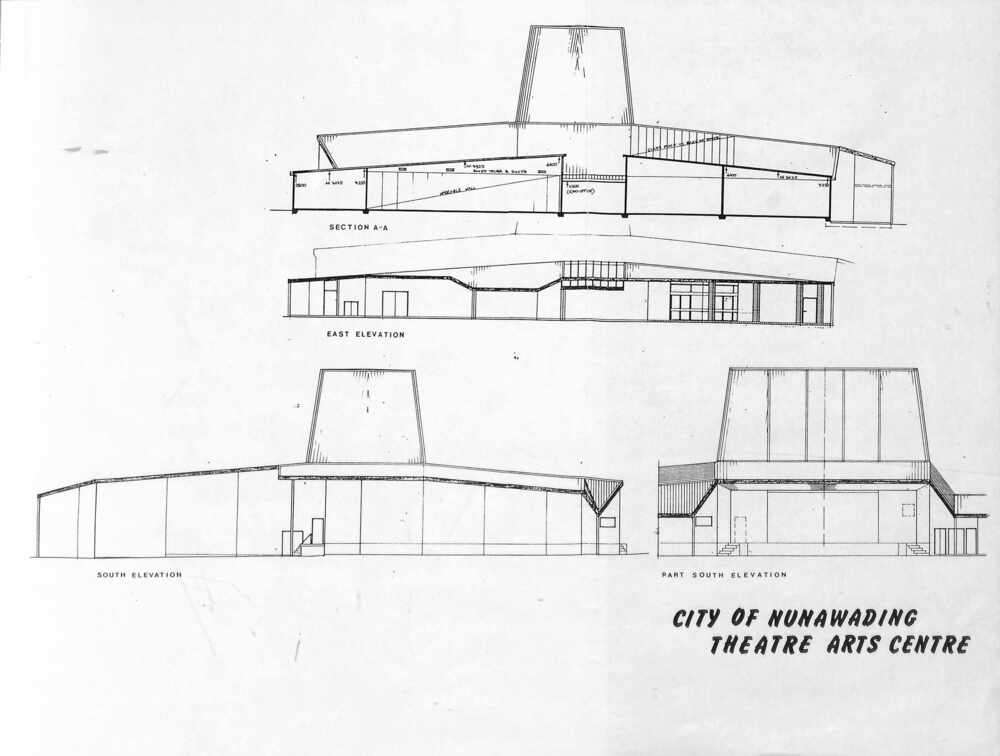

A building progress report (Development Report No.2) for the City of Nunawading Theatre Arts Centre by architect David Gawler, dated 10/5/1984. It includes the impact of regulations, acoustic considerations, review of user needs, structural review, electrical and sound systems, service requirements, car parking and access, description of facilities, revised cost estimates, timing, funding. Building site and elevation plans are attached.
Publication type
non-fiction
Summary
Building Progress Report - Development Report No 2, City of Nunawading Theatre Arts Centre dated 10 May 1984. It includes, site plans, costings and specifications.
