Physical description
Foolscap sized document.
Inscriptions & markings

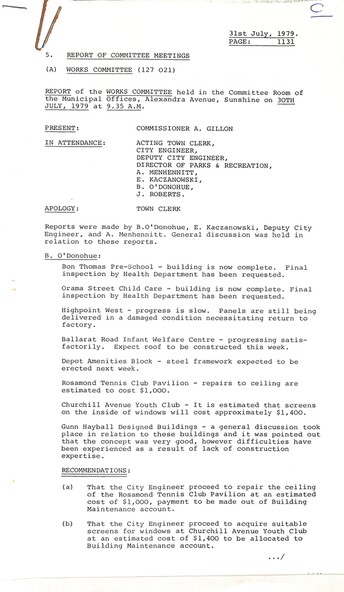

Reports of Committee Meetings 31st July 1979
Report of the Works Committee
Bon Thomas Pre-School Building Completed
Orama Street Child Care Building Completed
Highpoint West Child Care Building Progress is Slow
Ballarat Road Infant Welfare Centre Progressing Satisfactorily
Depot Amenities Block Street Frame to be Erected Next Week
Rosamond Tennis Club Pavilion Ceiling Repairs Costs
Church avenue Youth Club Window Screen Costs
Gunn Hayball Designed Buildings Discussion
Kerb & Channel Melon Street Completed
Kerb & Channel Ballarat Road Service Road Near Verdant Avenue Completed
Kerb & Channel Burn Street Commenced
Kerb & Channel Brisbane Street Commenced
Footpath Ashley Street Completed
Footpath Lynch Street Completed
Footpath Joy Street Area Progressing
Roadworks Melon Street Area Completed
Roadworks Municipal Sunshine Tip Surrounding Gatehouse has been sealed
Roadworks Ballarat Road Service Road Near Verdant Avenue Near Completion
Roadworks Parsons Resave Maintenance Works to Car Park Entrance and Car Park Completed
Drainage Ballarat Road Service Road Near Verdant Avenue Progress is slow due to Rock
Drainage Mernda Street Completed
Drainage Burns Street Completed
Drainage Robert Barrett Reserve Commenced
Garbage Skips Within One Week the Whole of the City Would have been serviced by a skip. This has taken approximately 18 months
C.R.B. & Other Works Duke Street Hotmix Completed
C.R.B. & Other Works Market Road Hotmix Completed
C.R.B. & Other Works South Road All Excavations Completed
C.R.B. & Other Works Sydney Street Naturestrip and Top Soil
C.R.B. & Other Works Hulett Street Final Hotmix to be poured
C.R.B. & Other Works Mechanical Wheel Washing Repairs Fixed
C.R.B. & Other Works Cornhill Street Right of Way Kerb & Channel Completed
C.R.B. & Other Works Neale Road Construction (Northen Carriage Way) Progressing
C.R.B. & Other Works Gillon Court Water & Gas Supply Laid
C.R.B. & Other Works Forrest Street (Bridge to Adelaide Street) Asphalting Completed
C.R.B. & Other Works Ballarat Road Near Verdant Avenue Asphalting Completed
C.R.B. & Other Works Churchill Avenue Car Park Asphalting Completed
C.R.B. & Other Works Simmie Street Asphalting
C.R.B. & Other Works Station Road (Dumfries Street to Mawson Street) Asphalting
C.R.B. & Other Works King Edward Avenue (Stages 1 & 2) Asphalting
C.R.B. & Other Billingham Road Drain
C.R.B. & Other Stony Creek Concrete Open Drain Furlong Road South to Cary Street
Diamond Avenue Pre-School Landscaping Progressing
Bon Thomas Reserve Pre-School Agricultural Drains Completed
Tree Planting Southern & Central Wards Completed
Tree Pruning 40% Complete
Northumberland Road Playground Graded and Top Soil Completed
General Reserve Maintenance Grass Growth is Slow
Dobson Reserve & Kinder Smith Reserve Quotations are being sourced
Maidstone Area Gang of Two Clearing Laneways
Killeen Street Child Care Landscaping Works Completed
Report of the Finance Committee
Report of the Town Clerk
Financial Reports for the Period Ended 2nd July 1979
Report of the City Engineer & Planner
Contract Cornhill Street Right of Way
South Road Reconstruction Refund from Department of Housing and Construction
Report of the Agenda and Forward Planning Committee
